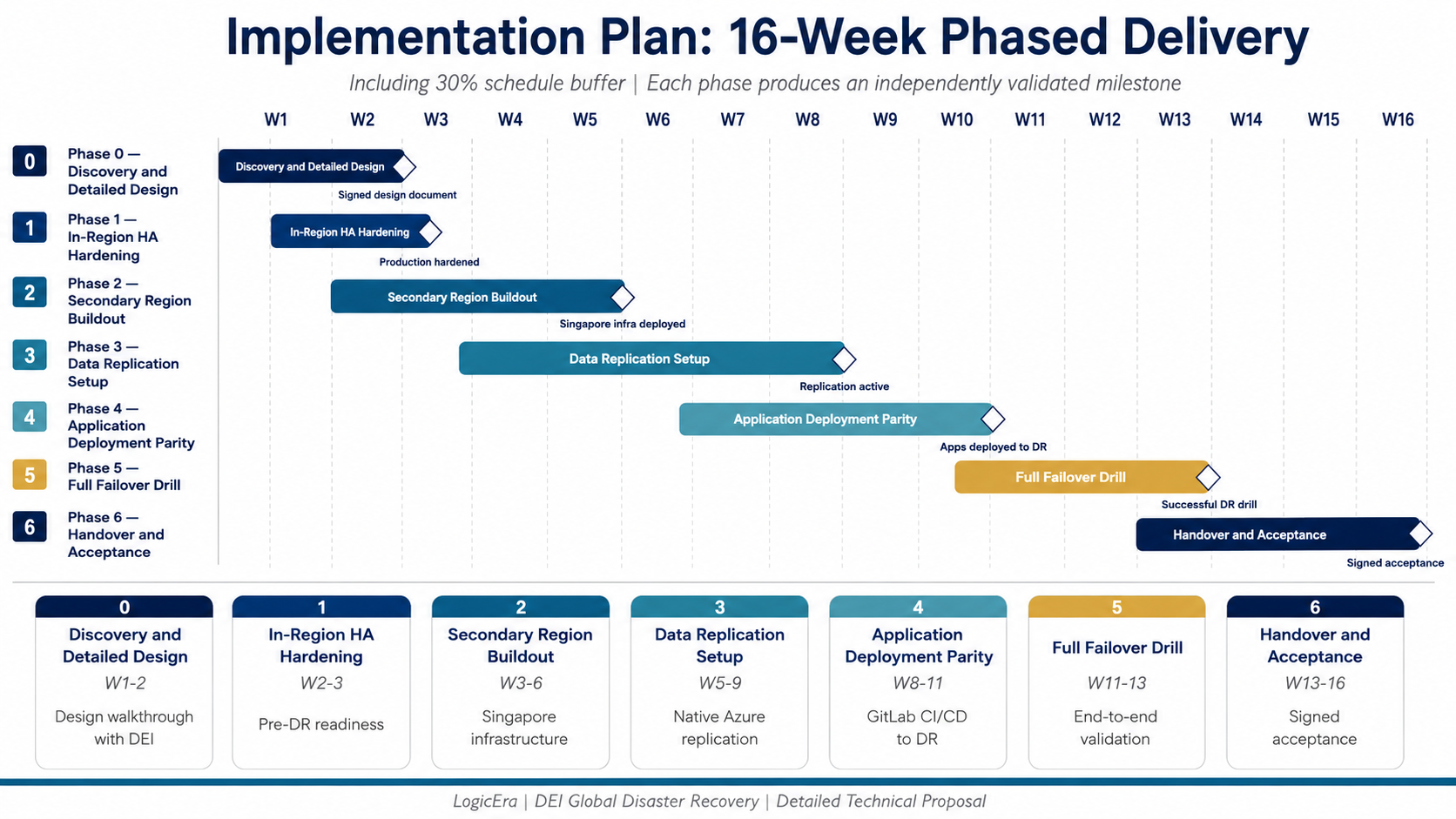

16 weeks, 7 phases (Phase 0 through Phase 6), 30% schedule buffer
Detailed Engagement Timelines
Discovery and Detailed Design
Weeks 1-2
DR-Readiness Foundations
Weeks 2-3
Secondary Region Buildout
Weeks 3-6
Data Replication Setup
Weeks 5-9
App Deployment Parity
Weeks 8-11
Full Failover Drill
Weeks 11-13
Handover and Acceptance
Weeks 13-16
